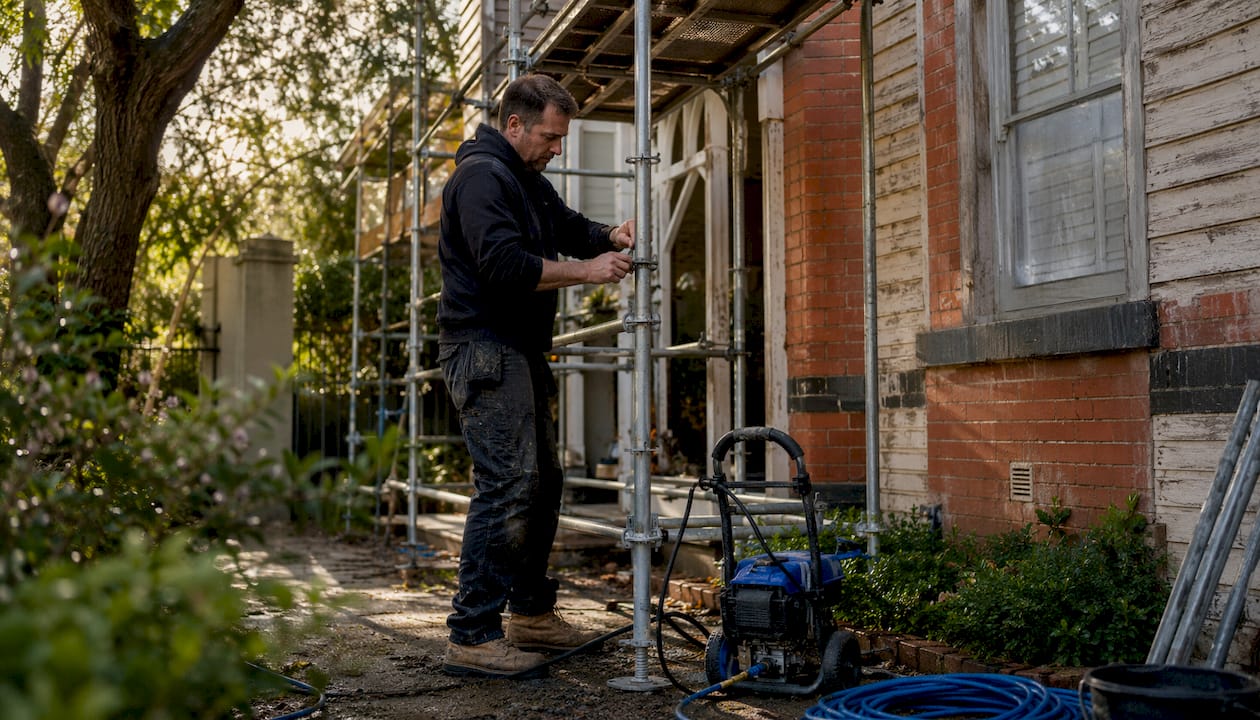

TL;DR:
- Preparing a period home thoroughly before repainting avoids delays and costly mistakes. Homeowners should confirm paint colours, arrange repairs early, and clear rooms days before painters arrive. Proper planning and expert repairs ensure the paint job lasts in Melbourne’s challenging climate.
Start preparing your inner east home for repainting several weeks before the painters arrive: confirm your colour scheme and scope in writing, check for heritage overlays, arrange any specialist repairs, and clear rooms a few days out. That sequence prevents the delays that push out timelines on period homes in Kew, Hawthorn, Camberwell, and surrounds.
Immediate homeowner checklist
- Confirm colours and scope in writing with your painter — 1–4 weeks out; allows time for sample boards and approvals
- Check your council overlay (Heritage Overlay, Neighbourhood Character) — 2–4 weeks out; some colour changes require consent
- Arrange lead-paint testing if your home was built before 1970 — 2–4 weeks out; testing and containment must be confirmed before any sanding begins
- Book specialist trades (carpenter, renderer) for rot or render repairs — 2–4 weeks out; trades in the inner east book out quickly
- Clear small items from rooms and roll up rugs — 2–3 days out; painters need 1.5–2 metres clearance from every wall
- Remove window treatments, switch plates and outlet covers — 2–3 days out; speeds up cutting-in and produces cleaner lines
- Unlock side gates and clear garden beds adjacent to exterior walls — morning of; painters need unobstructed access
- Move vehicles, pots and outdoor furniture away from the façade — morning of; scaffolding and ladders need a clear set-down zone
- Secure pets and arrange alternative accommodation for them if needed — morning of; exterior works involve ladders, chemicals and open gates
Table of Contents
- How should you assess the job and plan your prep timeline?
- Step-by-step exterior preparation for Melbourne conditions
- What do you need to do inside before painters arrive?
- Heritage overlays and council approvals: what inner east homeowners must check
- Which repairs will delay your repaint, and when should you call a specialist?
- What paints and primers work best for Melbourne exteriors and heritage homes?
- What should homeowners do on the day painters arrive?
- How do you inspect the finished work and plan ongoing maintenance?
- How Sol Shine prepares and delivers repaint projects in the inner east
- Key takeaways
- A local painter’s perspective on what actually matters
- Sol Shine: full-service preparation and heritage repainting for inner east homes
- Further reading and useful resources
How should you assess the job and plan your prep timeline?
The most reliable way to scope a repaint is to walk the property twice: once in morning light and once in the late afternoon. Inspecting under different lighting conditions reveals nail pops, peeling edges and glossy patches that flat midday light hides entirely. Those defects will show through fresh paint if they are not addressed first.

Work through the exterior cladding and trim methodically. Press a screwdriver gently into any timber that looks discoloured or soft. Check render for hairline cracks, bulging sections or hollow spots (tap with a knuckle — a dull thud indicates delamination). Note any rust streaking from metalwork, and look at flashings, sills and downpipe brackets for paint failure. Inside, check ceilings for water stains that signal an active leak; painting over a leak is money wasted.
Recommended lead times for inner east repaint projects
| Task | Recommended lead time | Notes |
|---|---|---|
| Finalise colours and confirm scope in writing | 4 weeks | Allows time for sample boards and heritage adviser review |
| Heritage overlay / council approval | 3–4 weeks | Some councils require written consent for colour changes on listed properties |
| Lead-paint testing (pre-1970 homes) | 2–4 weeks | Containment protocols must be in place before sanding or scraping |
| Specialist trades (carpenter, renderer, glazier) | 2–4 weeks | Inner east tradespeople book out; allow buffer for material lead times |
| Full-house interior clear and fixture removal | 2–3 days | Physical preparation can begin closer to the start date once trades are confirmed |
| Single-room interior prep | 1–2 days | Smaller scope; still remove all wall décor and window treatments |
When approvals or lead testing are involved, begin the process four weeks out. Leaving it to the last moment is the single most common reason heritage repaint projects in Hawthorn and Camberwell run late.
Pro Tip: Inspect exterior cladding and trim under raking afternoon light with a torch held at a low angle to the surface. This technique reveals nail pops, fine cracks and surface undulation that are invisible in direct sunlight — and that will telegraph through even a premium topcoat if left unaddressed.
Step-by-step exterior preparation for Melbourne conditions

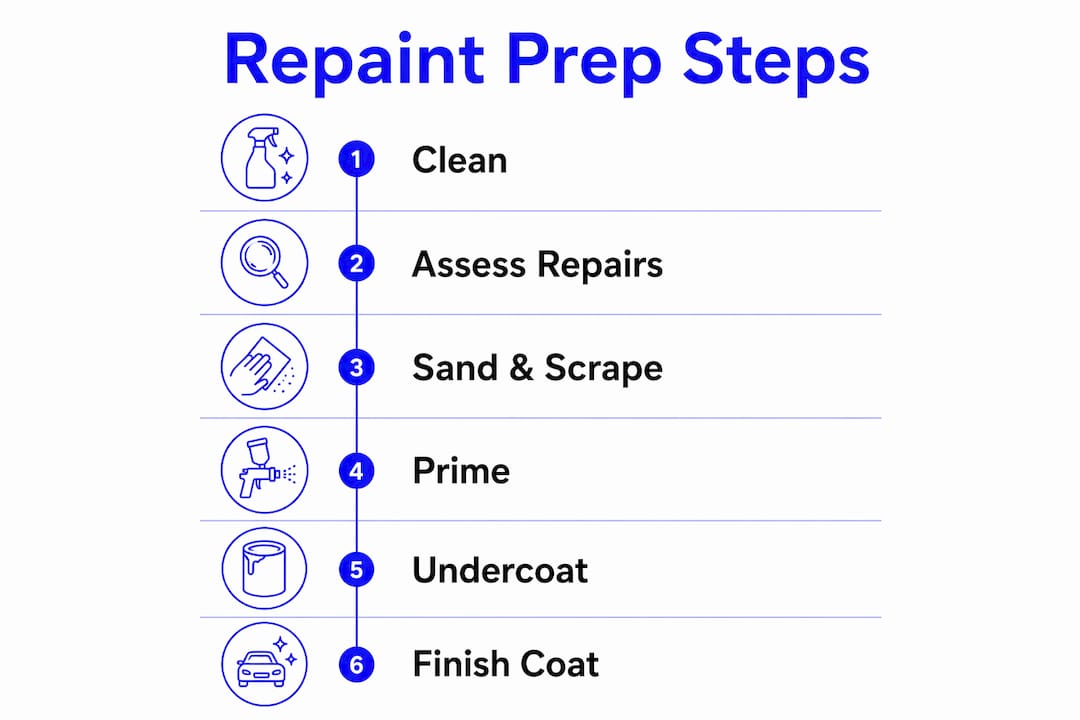

The correct sequence for exterior prep is: clean, then assess and repair, then sand and scrape, then prime, then undercoat and topcoat. Skipping or reversing steps — particularly priming before repairs are complete — is the most common cause of premature paint failure on Melbourne’s weatherboard and rendered homes.

Melbourne’s climate adds a specific challenge. The city’s UV intensity, wind-driven rain and occasional salt exposure on bayside properties mean surface preparation must be thorough, not just cosmetic. A coat applied over contaminated or poorly adhered substrate will fail within two to three seasons regardless of the product used.
The exterior prep sequence
- Pressure wash all surfaces — Use a low-to-medium pressure setting (1,200–1,500 PSI) on timber and render; higher pressure can drive water into joints or lift fragile render. Allow 24–48 hours drying time before proceeding. Protect garden beds and plants during washing; see Sol Shine’s guidance on protecting your garden during exterior works.
- Scrape and sand loose or flaking paint — Work from top to bottom. Use a carbide scraper on weatherboards and a flexible scraper on render. Sand edges of scraped areas to a feathered finish so topcoats don’t telegraph a hard line. For homes built before 1970, confirm lead-paint test results before any dry sanding; wet sanding or chemical stripping may be required under WorkSafe Victoria containment protocols.
- Repair timber rot, render cracks and metalwork rust — Soft or punky timber must be cut out and replaced; filler alone will not hold. Hairline render cracks can be raked out and filled with a flexible acrylic compound; structural cracks or hollow sections require a renderer. Rust on metalwork needs mechanical removal to bare metal before priming.
- Prime all bare substrates — Bare timber takes an oil-based or water-based timber primer; bare render takes a breathable masonry primer; bare metal takes a rust-inhibiting primer. Never apply a topcoat directly to bare substrate. For detailed guidance on substrate-specific priming, Sol Shine’s surface prep guide covers each material type.
- Apply undercoat where specified — Premium exterior systems such as Dulux Weathershield are designed to work as a system: primer, undercoat and topcoat. Skipping the undercoat reduces film build and shortens the coating’s service life.
- Apply topcoat in suitable conditions — Avoid painting in direct summer sun above 35°C, in high winds, or when rain is forecast within four hours. Melbourne’s spring and autumn windows (September–November and March–May) offer the most consistent conditions for exterior work.
Access and safety considerations
Multi-storey homes in Richmond, Fitzroy and East Melbourne often require scaffolding rather than ladders for safe access to upper-level weatherboards and eaves. Scaffolding also protects the footpath and neighbouring properties. Confirm with your painter whether a VBA-registered scaffolding contractor is required and whether a council permit is needed for scaffolding over the footpath. On narrow inner-east streets, parking and materials delivery need to be coordinated with the crew in advance.
Pro Tip: Schedule exterior painting to start on a Monday in spring or autumn. Melbourne’s Bureau of Meteorology data shows more stable, low-humidity conditions mid-week in those seasons, and a Monday start gives the crew a full week to complete prep and first coats before any weekend weather risk.
What do you need to do inside before painters arrive?
The three highest-value interior prep tasks are: clear all small items from the room entirely, push large furniture to the centre and cover it, and remove window treatments and switch plates. Painters can work around a room that has been properly cleared in a fraction of the time it takes to work around one that hasn’t.

Room-by-room guidance
Living areas and family rooms tend to have the most furniture and the most wall décor. Move everything small out of the room. Large sofas and bookshelves can be pushed to the centre and covered with drop sheets, but leave at least 1.5–2 metres of clear space from every wall. Unplug televisions and lamps; disconnecting electronics before painters arrive avoids accidental paint mist on screens.
Bedrooms require a little more care because of personal items. Clear nightstands, dressers and shelves completely. Move beds away from walls where the room allows. Remove anything from built-in wardrobes that are adjacent to walls being painted, and secure valuables in a locked room or off-site.
Kitchens present a grease challenge. Walls near the cooktop accumulate a film of cooking residue that prevents paint adhesion. Clean those surfaces with a sugar-soap solution before the painters arrive; it saves time and avoids adhesion failures. Clear countertops and relocate small appliances.
Bathrooms need the shower curtain, accessories and any wall-mounted items removed. Ventilation is critical in bathrooms: ensure the exhaust fan is accessible and functional, as cross-ventilation during and after painting speeds curing and limits odour spread.
Hallways and stairwells are high-traffic zones that painters need clear access through. Remove all wall photos and décor, lift runners and mats, and confirm that stair railings are accessible. These areas often take longer than expected because of the number of surfaces and angles involved.
Start the interior clear two to three days before painters arrive. That window gives you time to find a home for displaced items without rushing on the morning the crew shows up.
- Remove all wall décor, mirrors and artwork
- Take down curtains, blinds and curtain rods
- Roll up rugs and remove small mats
- Remove switch plates and outlet covers
- Push large furniture to the centre and cover with drop sheets
- Disconnect and cover electronics
- Clean kitchen walls with sugar soap where grease is present
- Arrange pets and children to be out of the work area
Pro Tip: Pack electronics, fragile heirlooms and irreplaceable items into sealed boxes and move them to a room that is not being painted. Paint mist travels further than most homeowners expect, and a sealed box is far more reliable than a drop sheet for protecting a vintage lamp or a framed artwork.
Heritage overlays and council approvals: what inner east homeowners must check
For most repaints in Melbourne’s inner east, you do not need council approval if you are repainting in the same colour. If you are changing the colour of a property subject to a Heritage Overlay (HO) or Neighbourhood Character Overlay (NCO), you may need a planning permit or, at minimum, written council advice before work begins. The rule of thumb: check first, paint second.
The inner east suburbs — Kew, Hawthorn, Camberwell, Malvern, Richmond and surrounds — have a high concentration of Heritage Overlays. Check your property’s overlay status on VicPlan before confirming any colour scheme with your painter. Many councils in the Boroondara and Stonnington areas publish heritage colour palettes and will provide informal advice before a formal application is lodged.
Council action list for heritage homeowners
- Search your property on VicPlan to identify any Heritage Overlay, Neighbourhood Character Overlay or Significant Landscape Overlay
- Contact your council’s planning department for informal colour advice before committing to a scheme
- If a permit is required, allow three to four weeks minimum for assessment; complex applications take longer
- For strata or body corporate properties, obtain written approval from the owners corporation before any external colour change; Sol Shine’s strata painting guide explains the approval process in detail
- Engage a heritage consultant if the property is individually listed or if the council requests a heritage impact statement
- Ask your painter to prepare physical sample boards using the proposed colours; councils respond better to boards than to digital swatches
Pro Tip: When briefing a heritage painter, document the proposed colours by product name and code (for example, Dulux Lexicon Quarter), the substrate and the finish level. A written brief with physical sample boards makes council assessment faster and reduces the risk of a permit condition requiring you to repaint.
The period home painting checklist Sol Shine has developed for Melbourne owners covers the heritage approval steps in sequence and is worth reviewing before your first council contact.
Which repairs will delay your repaint, and when should you call a specialist?
The three repairs most likely to extend your prep timeline are timber rot, render failure and extensive rust on metalwork. Each requires a specialist trade, and each adds time and cost to the project scope. Identifying them early is what separates a well-managed repaint from one that stalls on site.
Timber rot is the most common issue on Victorian and Edwardian weatherboard homes in the inner east. Press a screwdriver into any discoloured or soft-looking timber. If it sinks more than a few millimetres, the timber is compromised and must be replaced, not filled. A painter can fill surface checks and minor cracks, but structural rot requires a carpenter. Typical lead time for a carpenter in Melbourne’s inner east is one to two weeks.
Render failure on brick or bluestone homes shows as hollow sections (tap with a knuckle for a dull thud), bulging, or large map-cracking patterns. Hairline cracks can be raked and filled by a painter using a flexible acrylic compound. Hollow or delaminated render must be removed and replaced by a renderer before any paint is applied. Skipping this step means the new coat will lift with the render beneath it.
Rust on metalwork — gutters, downpipe brackets, window hoods and decorative cast iron — needs mechanical removal to bare metal before priming. Surface rust treated with a topcoat alone will bleed through within one to two seasons.
Repairs that are typically outside a painter’s scope and will add to your timeline:
- Structural timber replacement (fascias, weatherboards, window sills with active rot)
- Re-rendering of hollow or delaminated sections
- Glazing repairs or replacement of cracked heritage window panes
- Roof repairs where water ingress is causing interior staining
- Repointing of brickwork or bluestone mortar joints
- Replacement of damaged or missing cast-iron decorative elements
Budget two to four weeks for specialist trades before painting begins on a property with multiple repair items. Sol Shine’s exterior trim repair examples show the scope of work that commonly precedes a repaint on period homes in the inner east.
What paints and primers work best for Melbourne exteriors and heritage homes?
For Melbourne exteriors, specify a premium exterior paint system with a dedicated primer and undercoat. A single-coat, all-in-one product applied directly to bare or weathered substrate will not perform in Melbourne’s UV and rain exposure. The product choice and the system approach together determine how long the coating lasts.
Dulux Weathershield is one of the most widely specified exterior systems for Melbourne homes. It is formulated for Australian UV and weather conditions, carries a manufacturer’s warranty when applied as a full system, and is available in a broad colour range suited to heritage palettes. For weatherboard homes in Kew or Hawthorn, Dulux Weathershield applied over a compatible Dulux primer and undercoat gives a durable, washable finish that holds colour well over multiple seasons.
Dulux interior and exterior ranges more broadly offer substrate-specific primers that are worth specifying by name in your scope of works. A solvent-based timber primer on bare or previously oil-painted timber outperforms a water-based primer in penetration and adhesion, particularly on older, porous weatherboards.
Recommended product types by substrate
- Bare or stripped timber: solvent-based or water-based timber primer, followed by a compatible undercoat and two topcoats
- Bare or repaired render: breathable masonry primer to allow moisture vapour transmission; avoid non-breathable sealers on old lime render
- Bare metal (gutters, brackets, cast iron): rust-inhibiting metal primer before any topcoat; two-pack epoxy primer for high-exposure metalwork
- Previously painted surfaces in good condition: a light sand and a compatible undercoat or direct topcoat depending on the paint system
- Heritage joinery and sills: flexible acrylic sealant at all joints before priming; prevents water ingress at the most vulnerable points
For bayside properties in Brighton or Sandringham, salt-laden air accelerates paint breakdown at joints and edges. Specify a primer with enhanced salt resistance and inspect sealant joints annually. Sol Shine’s guidance on preserving timber exteriors on heritage homes covers the maintenance intervals that protect the coating investment.
What should homeowners do on the day painters arrive?
The core day-of responsibilities are: provide clear access, confirm parking arrangements, secure pets, open windows for ventilation, and have a single point of contact available by phone. A crew that arrives to a locked gate, no parking and an uncontactable owner loses an hour before a brush is lifted.
Morning checklist for the day painting starts
- Unlock all gates, side access and any padlocked areas the crew needs to reach
- Move vehicles from the driveway and any street spots the crew has flagged for materials delivery
- Secure pets in a room not being painted, or arrange for them to be off-site for the day
- Open windows in rooms being painted to establish cross-ventilation before work begins
- Confirm the start time, parking arrangements and power access with the crew leader
- Point out the nearest hand basin and confirm where waste materials can be staged
- Have the written scope and any colour approval documents ready to hand over
Communication on the day
If an issue arises on site — a hidden repair, a product substitution, a weather delay — the crew leader should contact the homeowner before proceeding, not after. Agree on this protocol at the start of the day. For heritage properties where colour approvals are in place, any deviation from the approved scheme must be confirmed in writing before paint is applied. Keep a copy of the written scope and colour codes on site throughout the project.
A step-by-step painting workflow tailored to Melbourne conditions, including neighbourhood logistics, is available from Sol Shine for homeowners who want to understand the full sequence from day one through to completion.
How do you inspect the finished work and plan ongoing maintenance?
Walk the property in natural light and again under artificial light after the final coat has cured. Natural light reveals colour consistency and sheen variation; artificial light picks up surface texture issues, lap marks and missed spots. Use a printed checklist so nothing is overlooked.
Post-paint inspection checklist
- Edges and cut-in lines at ceilings, skirtings and window frames: check for clean, straight lines
- Window sills and sill ends: confirm full coverage including the underside of sills
- Flashings and downpipe brackets: check that metalwork has been primed and topcoated
- Timber trim and heritage joinery: look for runs, sags or thin coverage on moulding profiles
- Flatness of finish on large wall areas: stand at a low angle to the wall and look for roller texture inconsistency
- Colour consistency across the full façade: check that all panels and sections match
- Sealant joints at windows and doors: confirm sealant has been applied and is smooth
Document any defects with photographs and a written list before the crew leaves site. A professional painter will return for touch-ups within an agreed period; confirm this in writing as part of the contract.
Maintenance and re-paint intervals
Melbourne exteriors on weatherboard homes typically need regular inspection and a full repaint at multi-year intervals, depending on aspect, tree cover and product quality. North and west-facing walls receive the highest UV load and will show colour fade and surface chalking first. Inspect sealant joints and timber end-grain annually; these are the points where water enters and accelerates paint failure. A timber sealing programme for exposed joinery extends the interval between full repaints.
How Sol Shine prepares and delivers repaint projects in the inner east
Sol Shine’s workflow for heritage repaint projects follows four stages: site survey and defect mapping, specialist repairs, sample board approval, and the paint programme. That sequence means no surprises on site and no colour disputes after the first coat goes on.
A typical Sol Shine project on a Victorian or Edwardian home in the inner east begins with a detailed site survey. The team maps every repair item — soft timber, hollow render, failed sealant joints, rust on metalwork — and produces a written scope before any pricing is confirmed. Specialist trades (carpentry, rendering, glazing) are coordinated directly by Sol Shine, so the homeowner deals with one point of contact rather than managing multiple contractors.
Sample boards are prepared in the proposed colours on the actual substrate of the property. For heritage-listed homes, those boards are submitted to council or the heritage adviser as part of the approval process. Paint does not go on until the board is approved and the written scope is signed.
Sol Shine’s exterior painting portfolio includes completed projects across Kew, Hawthorn, Camberwell, Richmond and East Melbourne, covering full exterior repaints, timber restoration, render repair and heritage joinery work. Interior projects are documented separately in the interior painting archives.
Projects in the inner east typically involve period homes with multiple repair items, multi-storey access requirements and heritage colour constraints. A realistic project scope for a full exterior repaint with repairs on a Victorian or Edwardian home in this area starts at $20,000 and scales with the extent of timber replacement, render work and access complexity. Sol Shine works directly with homeowners on projects of this scale, managing the full scope under one roof.
Key takeaways
Thorough preparation, confirmed in writing at least four weeks before painters arrive, is what separates a durable heritage repaint from one that fails prematurely or runs over time and budget.
| Point | Details |
|---|---|
| Confirm scope and colours early | Finalise colours and written scope at least four weeks out to allow for heritage approvals and sample boards. |
| Check your heritage overlay | Search your property on VicPlan before committing to a colour change; some inner east properties require a planning permit. |
| Arrange specialist repairs first | Timber rot, render failure and metalwork rust must be fixed by specialist trades before painting begins; allow two to four weeks for bookings. |
| Clear rooms two to three days out | Leave clearance from all walls; remove window treatments, switch plates and all small items before painters arrive. |
| Sol Shine for heritage repaints | Sol Shine manages survey, repairs, sample board approval and the full paint programme for period homes in Melbourne’s inner east. |
A local painter’s perspective on what actually matters
The homeowners who get the best results are the ones who treat preparation as part of the project, not a chore before it starts. When a crew arrives to a property where the scope is confirmed in writing, the repairs are done, and the rooms are clear, the painting itself is straightforward. When they arrive to discover soft timber that nobody checked, or a colour that hasn’t been approved by the heritage adviser, the project stalls before a brush is lifted.
The single habit worth adopting: walk your property with a screwdriver and a torch before you call a painter. Press the timber. Tap the render. Look at the sills and the end-grain on the fascias. That ten-minute inspection will tell you more about your project scope than any quote you receive without it. Painters who do thorough site surveys before pricing are the ones worth hiring; the ones who quote from the street are the ones who find surprises on day one.
Sol Shine: full-service preparation and heritage repainting for inner east homes
For homeowners in Melbourne’s inner east, Sol Shine offers something most painting contractors cannot: a single point of contact for the entire project, from defect survey and specialist repairs through to the final coat and touch-up inspection.

Sol Shine is a professional painting and heritage restoration specialist based in Melbourne, servicing Kew, Hawthorn, Camberwell, Malvern, Richmond, Fitzroy and surrounding suburbs. The service covers exterior and interior painting, roof painting, timber sealing, weatherboard replacement, render repair, brickwork, damaged window repairs, multi-storey access, timber restoration, custom joinery and architectural woodwork for Victorian and Edwardian homes. Projects are typically $20,000 and above, handled entirely in-house with skilled, trustworthy craftsmanship.
To view completed projects or to arrange a site visit and written quote, contact Sol Shine directly or browse the exterior painting portfolio for examples of heritage repaint work across the inner east.
Further reading and useful resources
- VicPlan (mapshare.vic.gov.au) — Check your property’s Heritage Overlay, Neighbourhood Character Overlay and planning controls before confirming any colour change
- WorkSafe Victoria (worksafe.vic.gov.au) — Lead-paint handling requirements and containment protocols for pre-1970 homes
- Victorian Building Authority (vba.vic.gov.au) — Verify contractor registrations and understand scaffolding permit requirements for multi-storey work
- EPA Victoria — lead contamination (epa.vic.gov.au) — Background on lead risks relevant to older Melbourne properties
- TradieVerify AU — homeowner prep checklist — Practical checklist covering interior and exterior preparation tasks and timing
- Sol Shine articles and guides (solshine.com.au) — Resource hub covering surface prep, heritage painting, timber sealing and Melbourne-specific painting advice
- Sol Shine — period home painting checklist — Heritage-specific checklist for Melbourne period homes, covering approvals, repairs and colour selection
- Sol Shine — surface prep guide — Substrate-by-substrate guidance on priming and preparation for timber, render and metal
For any item that requires a site inspection to assess properly, contact Sol Shine for a written evaluation before committing to a scope or a product specification.
